Planning View

Other planning views

Planning global

Global planning

Global planning

The global planning allows to create and visualize any type of element (project, activity, milestones, risk, meeting, action …)

Create a new item

Create a new item

  • Add and Show any new planning element on Gantt chart

  • The created item is added in the Gantt and detail window is opened.

  • The detail window allows to complete entry

  • Project planning and activity planning calculation can be done in the Gantt.

Display items

Display items

  • Requirements can be displayed but you will not be able to create them from the planning view

Projects portfolio

This screen displays only the projects on the diagram. The activities and other elements that make up the planning are hidden.

Displaying the columns corresponding to the project fields behind the slider allows you to display all the information about your project in a single view: status, priority, dates, charges, duration, costs, etc.

The possibility of displaying personalized fields using the customization plugin is also possible. Click the Columns button to choose which fields to display.

It displays milestone and project dependencies only.

Note

This section describes specific behavior for this screen. All others behaviors are similar to Gantt Chart screen.

Gantt (Projects portfolio)

Gantt (Projects portfolio)

Show milestones

  • You have the option to show or hide milestones.

  • It is possible to define the type of milestone to display. All milestones are available: deliverable, incoming, key date, etc.

  • The milestones are displayed directly on the bar of your project.

Projects portfolio columns

Projects portfolio columns

As in the planning view, you display a menu dedicated to the portfolio view by right-clicking on the list of projects.

Right menu

Right menu

Resource planning

This screen displays the Gantt chart from a resource perspective.

The assigned tasks are grouped under the resource level.

Regarding resource planning, periodic group meetings are under his responsibility.

Ability to view assigned activities without charge.

Gantt (Resource planning)

Gantt (Resource planning)

Limit display to selected ressource or team

  • Click and select one ressource to display only his data.

  • Click and select one team to display only data of resources of this team.

  • Click and select one organization to display only data of resources of this organization.

Gantt charts for resources

The bars used in the Gantt chart for resources differ slightly from the standard planning bars.

Most of the bars used in the Gantt chart are the same as for standard planning.

See: Gantt chart’s bars.

GREY BAR

all is well

all is well

Condition: Assigned resources are available and meet workload, validated or scheduled dates do not conflict with other items.

The gray bar in the middle graphically represents the actual percentage progress relative to the total duration of the activity.

This makes appear some planning gap between started work and reassessed work.

Dependencies behavior

  • Links between activities are displayed only in the resource group.

  • Links existing between tasks on different resources are not displayed.

Note

This section describes specific behavior for this screen.

All others behaviors are similar to Gantt Chart screen.

Tools

  • Click on calculate planning button to start the Planning calculation.

  • Click on Add to create a new element.

  • Click on Filters to apply many filters and manage Advanced filters.

  • Click on Columns organizer to organize the columns of the progress data view.

  • Click on Sub-menu to display the sub-menu.

  • Click on Switch mode to display this screen in horizontal or vertical mode.

Display dates

This functionality allows to define columns displayed in the progress data view.

More details: Display and organize the columns.

Display options into the subMenu

Display options are the same as on the planning view.

Gantt chart options

Gantt chart options

Global view

Global View Screen

Global view screen

The “Global view” screen lists all the main objects created during a project. This allows you to quickly search through all types of items available.

You can also choose to display only certain items through the list to display

display items

Display one or more items

Critical resource

The critical resources screen will allow you to identify the resources that will cause the project to drift and not miss certain key dates due to lack of capacity on the project.

This amounts to calculating the complete schedule and all your resources in infinite overbooking mode.

Planning in infinite overbooking mode

Planning in infinite overbooking mode

Critical resource list

The critical resources table tells you for each critical resource displayed:

Critical resources list

Critical resources list

  • The name of the resource

  • Its load available

  • Its load used

  • Overbooking load

  • Its rank (Index used to calculate the margin = difference between available - used)

This table of critical resources is broken down by project.

Projects using critical resources

The Projects using critical resources table allows you to visualize the number of days late per project and which resources are causing the delay.

The strategic value has no impact on the display of projects and the determination of critical resources. This (numerical) value is free and left to your discretion.

It can be a value between 1 and 100, or a number of Business, regardless, this will allow you to identify whether projects consuming critical resources are strategically sound and therefore worth implementing.

Critical resources planning

The Critical resources list by period table is a representation of the current planning, not the ideal planning.

The display will be done by period defined on the scale (week, month, quarter) or by displaying the “overbooking load” necessary to optimize the planning.

Critical resource screen

Critical resource screen

Formatting results and indicators

Indicator is a percentage = (Margin - Subooked) / Available (* 100)

  • Define threshold
    • Defaut Red = “< 20%”

    • Default Orange = “< 5%”

  • Late planning
    • In red, the resource does not have sufficient capacity to complete the task on time

    • planned end date > Validated end date - overbooking on the activity

  • Missing capacity
    • In yellow, the resource does not have sufficient capacity to complete the task on time but is not the cause of the task delay.

    • Planned end date > Validated end date - no overbooking

  • Optimal planning
    • In green, the resource has sufficient capacity to complete the task on time

    • Planned end date < Validated end date - no overbooking on the activity

Critical resources scenario

Without affecting your basic schedule, you can simulate starting one or more project(s) on later dates in months.

possible scenarios for a simulation on projects containing critical resources

possible scenarios for a simulation on projects containing critical resources

You can also add additional capacity to your pools to check if the possible addition of resources can improve the planning of your projects.

You can apply a particular date for the new capacity to be added which will decide when the new capacity can be added.

Critical resources work plan

You can obtain directly on the critical resources screen the report on the load planning on a selected resource for the indicated period.

load planning report for a resource

load planning report for a resource

Planning & Dynamic work plan

In addition to the planning view and the dynamic work plan view, ProjeQtOr offers a view that combines the two screens.

This screen allows you to quickly visualize how the load quantity affects the dates of your projects.

Planning and dynamic workplan screen

Planning and dynamic workplan screen

Note

The dynamic load plan combined with the planning was created for reading.

The table therefore does not offer the display options and restrictions proposed on the dedicated screen.

Projeqtor offers a dynamic view of the load plan of your resources.

You can view the past and forecast load as well as the future capacity of a resource or all resources and pools.

The display can be restricted using filters.

Dynamic Work plan

Dynamic Work plan screen

The graph will represent the past and future workload in the form of bars, similar to the Gantt bar detail and the resource or group capacity as a line.

The data is automatically limited to the data for the project(s) selected in the project selector.

Click on plus button to open the line of the resources.

All resources of the selected projects are displayed with the work details for each.

Work plan levels

Workplan level

Click again on the plus button of a resource to display all the activities on which the resource has work.

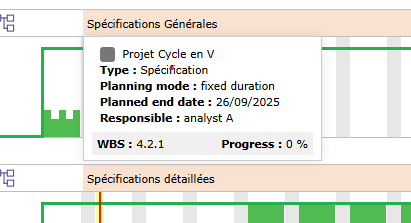

Hover over an activity to see its details

Details of the activity on dynamic workplan

Details of the activity on dynamic workplan

Tip

An option in the screen display options allows you to display the project level or not.

Many options allow you to customize the display of the dynamic work plan.

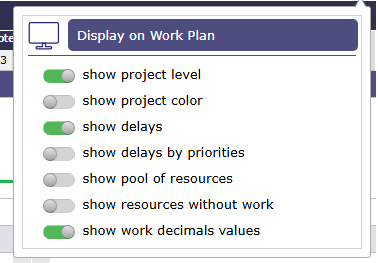

Dynamic Workplan options

Dynamic Workplan options

Show project levels

Allows you to have all the data of the elements making up the project on one line for a resource.

Show the project colors

Allows you to view the load bars in the color assigned to the project in the description section

Show delays

Allows you to view the load plan in the same colors as the bars in the Gantt chart.

Show delays by priority

This option, available only when “show delay” is enabled, will not use the Gantt view colors but the priority colors to manage.

Show pool of resources

Pools are a grouping of resources. Their scheduling is distributed across all or part of the group.

Show resources without work

When a resource has no more work to do, and therefore no more planned work, their row disappears, just like closed items.

You can therefore display all the resources in a project, even if no work has been assigned to them.

show work decimals values

Allows you to round or not round the values calculated by the software.

Color code

Different legends can be applied to the dynamic load plan and therefore change colors.

Mode normal

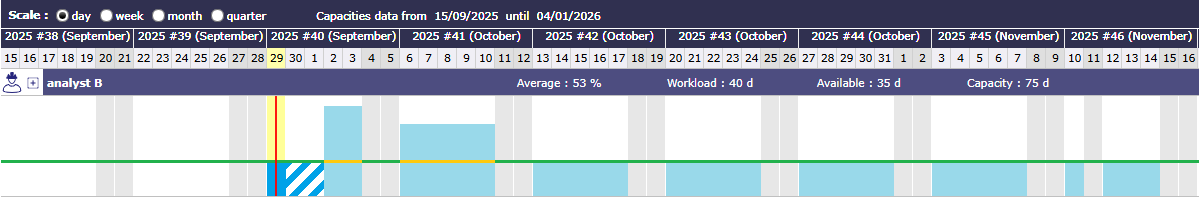

Normal mode shows projects in blue tones.

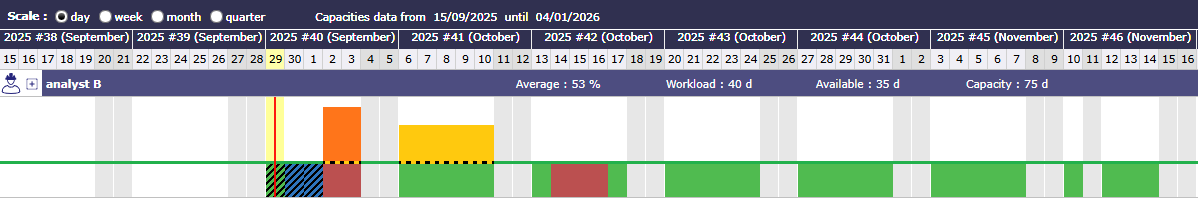

Dynamic Workplan

Dynamic workplan

Planned work Work left. Assigned work.

Real work Real work - charged to the timesheet.

Absence Absence

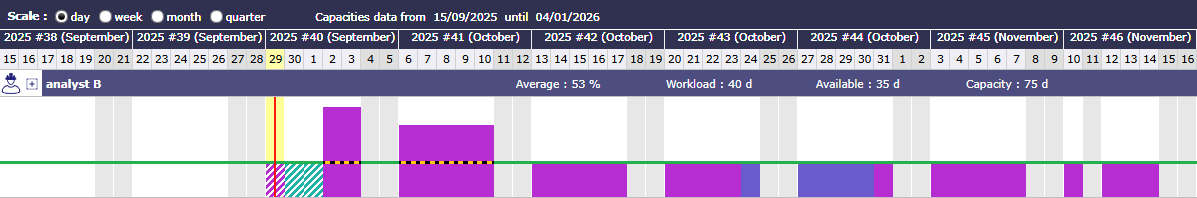

Mode Project color

allows you to display the bars in the project color. If the project has no color, the bars are displayed in gray.

Dynamic Workplan with project color

Dynamic workplan with project color

Mode Delays color

The deadline mode automatically unchecks the project color mode.

This allows you to return to the same colors as on the Gantt chart.

Dynamic Workplan with project color

Dynamic workplan with project color

Real work Real work

Real work Late real work

Planned work Work left. Assigned work.

Delays on work Late, but not overbooked.

Overbooked work overbooked, but no late.

Delays on Overbooked work overbooked and late.

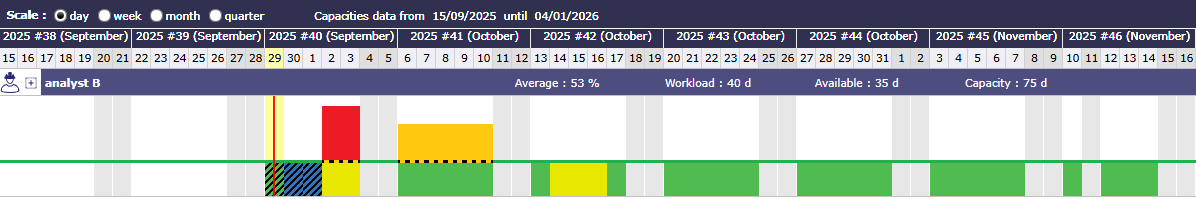

Mode Delays color with priorities

The deadline mode with priority visualization will change the colors of the delays.

This allows you to quickly identify the order in which tasks should be completed by highlighting those that are most late.

This will allow us to prioritize red activities, then orange activities, plus youth activities, leaving only green activities, so that everything is fine.

Dynamic Workplan with project color

Dynamic workplan with project color

Overuse priority Overbooked, but no late.

Overuse delays priority Overbooked and late.

Capacity

The line corresponds to the resource’s capacity.

It only changes color when the dynamic load plan is displayed in normal mode to indicate overutilization.

Capacity capacity value of the resources

Overbooking Overuse capacity value of the resources

Work plan with overbooking

Work plan with overbooking

When the schedule is displayed in other modes then the line is dotted black and yellow for better readability.

Capacity Line capacity value of the resources

Filters

On each line, we display:

  • The name of the resource or resource group preceded by its class icon.

  • Average capacity utilization = Sum (workload) / Sum (capacity) [expressed in %]

  • Planned work = Sum (workload) [expressed in days or hours]

  • Available = Sum (capacity) - Sum (workload) [expressed in days or hours]

Work information is displayed in days or hours depending on the overall load display setting for the selected period.

  • If a Pool is selected

The data in the graph represents the sum of the data in the Pool and the Resources in the Pool

  • If a Team or Organization is selected

The data in the graph represents the sum of the data in the Resources and Pools of the team or organization.

  • If no parameters are selected

The data in the graph represents the sum of the data for all Resources for which the current user is responsible (as listed in the Resource list on the Allocations screen)

Display periods and scales

The scale, which determines the display of the abscissas, is selected at the header level.

You can choose the same scales as for the planning view: day, week, month, quarter for displaying dates.

Display dates on Planning view

Display dates on Planning view

The choice of scale will determine:

  • The width of the display of a day, exactly as on the planning view

  • The granularity of the data display, on a daily or weekly basis, as is the case for the detail of a Gantt bar in the planning view

  • The choice of the period to display will be identical to the selection available on the Gantt with start date (positioned by default on the current date) and end date (empty by default).

  • the “entire project” option, which automatically determines the start and end date based on the data to be displayed (exactly as for the Planning view).

  • The choice of a duration filter, week, month, quarter, semester, year, will determine the end date automatically in the “display to” field.

  • The two scales are independent of each other and can be combined.

Work plan Scale of duration

Work plan - Scale of duration

Important

The display dates of the planning view and the dynamic load plan are linked.

When you select start and end display dates, they will be identical from one view to another.

If you change the display dates on the dynamic load plan screen, when you return to the planning view, these display dates will be applied automatically

Options

Several options give you the possibility to display the graph in different ways.

Options for the dynamic workplan

Options for the dynamic workplan

Project level

You can choose whether to display the resource’s workload for the entire project.

This option allows you to display an additional row and shows the resource’s total workload for the various activities in this project, which will be detailed at the next level.

Color by project

So, instead of just having dark blue for actual and light blue for planned, the load of each project will be displayed in the project color, if it is entered, or in the project type color if not.

The actual load will be distinguished by a hatching of the color.

load plan showing project colors

load plan showing project colors

Show delays

Show delays allows you to display the workload bars in the chart with the colors of the Gantt bars, indicating whether the work is “late” or not.

Show delays

Show delays

  • Green: Everything is fine

  • Red: The work is beyond the expected date

  • Orange: The planning is overbooking
